3rd Avenue Crescent Infrastructure Upgrades

The Town of Battleford is launching a comprehensive water and sewer replacement project along 3rd Avenue Crescent.

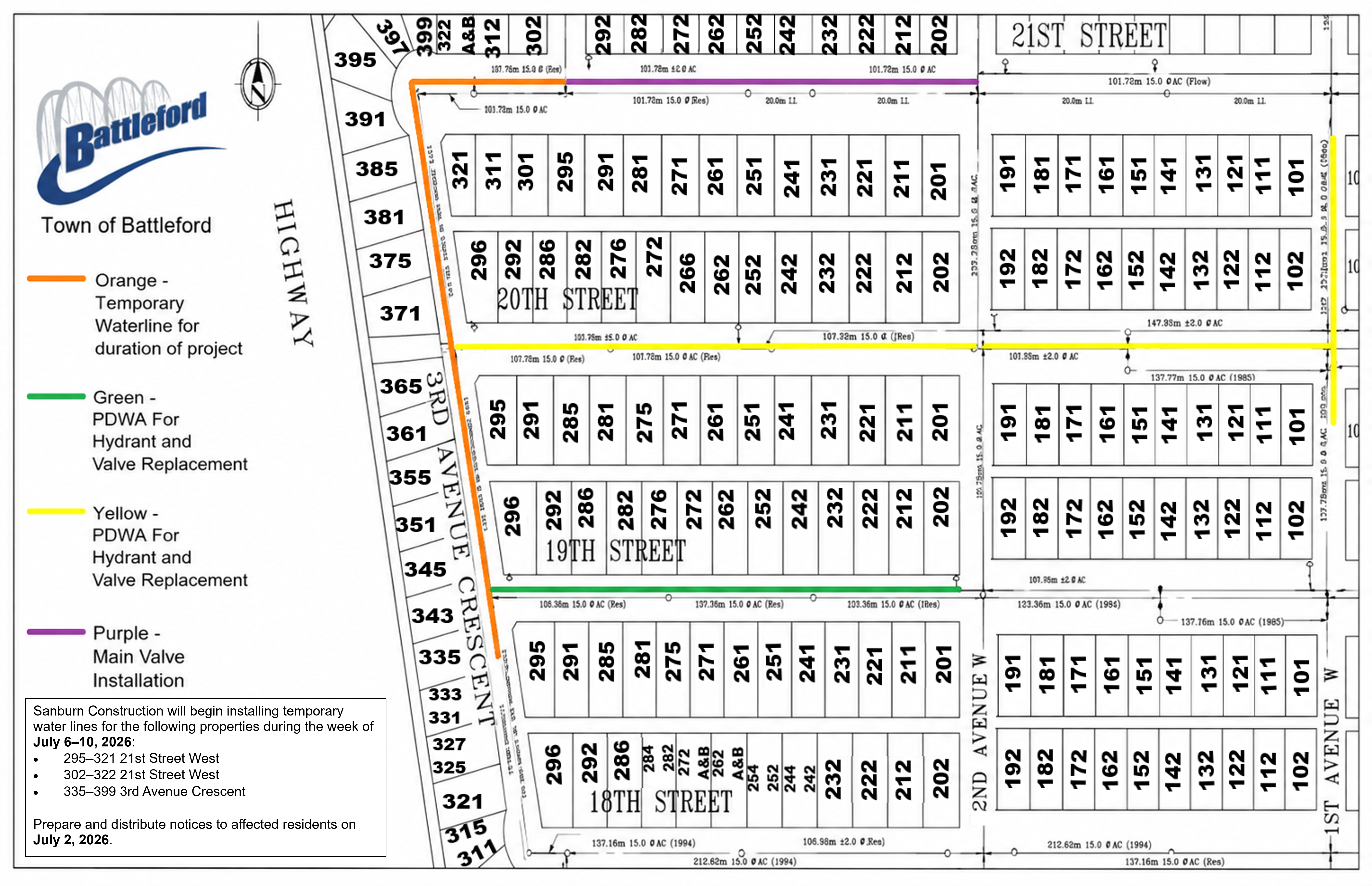

Click or tap the map image above to open it in full size.



🟢 CURRENT UPDATE: Week of July 6 – July 10, 2026

  • On the Ground: Site mobilization is underway. Crews are currently arriving on-site with heavy machinery and replacing main valves.

  • Water Hookups: Installation of the temporary overland water line is actively being laid out.

  • Traffic Impact: 3rd Avenue Crescent is experiencing temporary lane restrictions and rolling closures between 19th and 21st Street. Commuters are advised to use alternate routes.

  • Waste Collection: Standard pickup is currently running. Residents facing direct blockages will receive direct notice regarding modified bin placement.









📜 PAST UPDATES (Archived Progress)






📅 Estimated Project Schedule (Subject to Weather)

  • Mobilization & Temporary Water Setup
July 6 – July 10

Crews arrive on site, begin valve replacements, and install the temporary overland water system.

  • Water & Sewer Replacements (20th St to 19th St)
July 13 – July 31

Deep utility excavation, main replacements, services, and stubs begin from 20th Street to 19th Street.

  • Main Work Moves (20th St to 21st St)
Aug 4 – Aug 21

Water and sewer replacements move from 20th Street to 21st Street. Road base work begins from 19th Street to 20th Street.

  • Main Work Moves (21st St to 3rd Ave)
Aug 24 – Sept 11

Water and sewer replacements move from 21st Street to 3rd Avenue. Road base work shifts from 20th Street to 21st Street.

  • Testing & Switching Off Temporary Water
Sept 14 – Sept 18

Final block road base work, watermain testing, camera inspections, and the removal of all temporary water lines.

  • Surface Rebuilding & Paving
Sept 21 – Oct 15

Curb installation, sidewalk/pathway reconstruction, and final road paving.

  • Final Site Cleanup
Oct 19 – Oct 23

Demobilization and final site cleanup.
